Comment

Copper valuation ยท Step-by-step guide

Copper Mine Valuation: Build an NPV Model Step by Step

A copper mine is valued as the discounted after-tax cash flow it can earn. This guide builds that model in eight steps, using published study numbers from Warintza and Copper World, and shows how far price, cost and capital move the result.

Authored by Farmonaut Research & Content Team
Reviewed and verified by Farmonaut Mining & Mineral Exploration Team
Updated 16 October 2026 ยท 18 min read

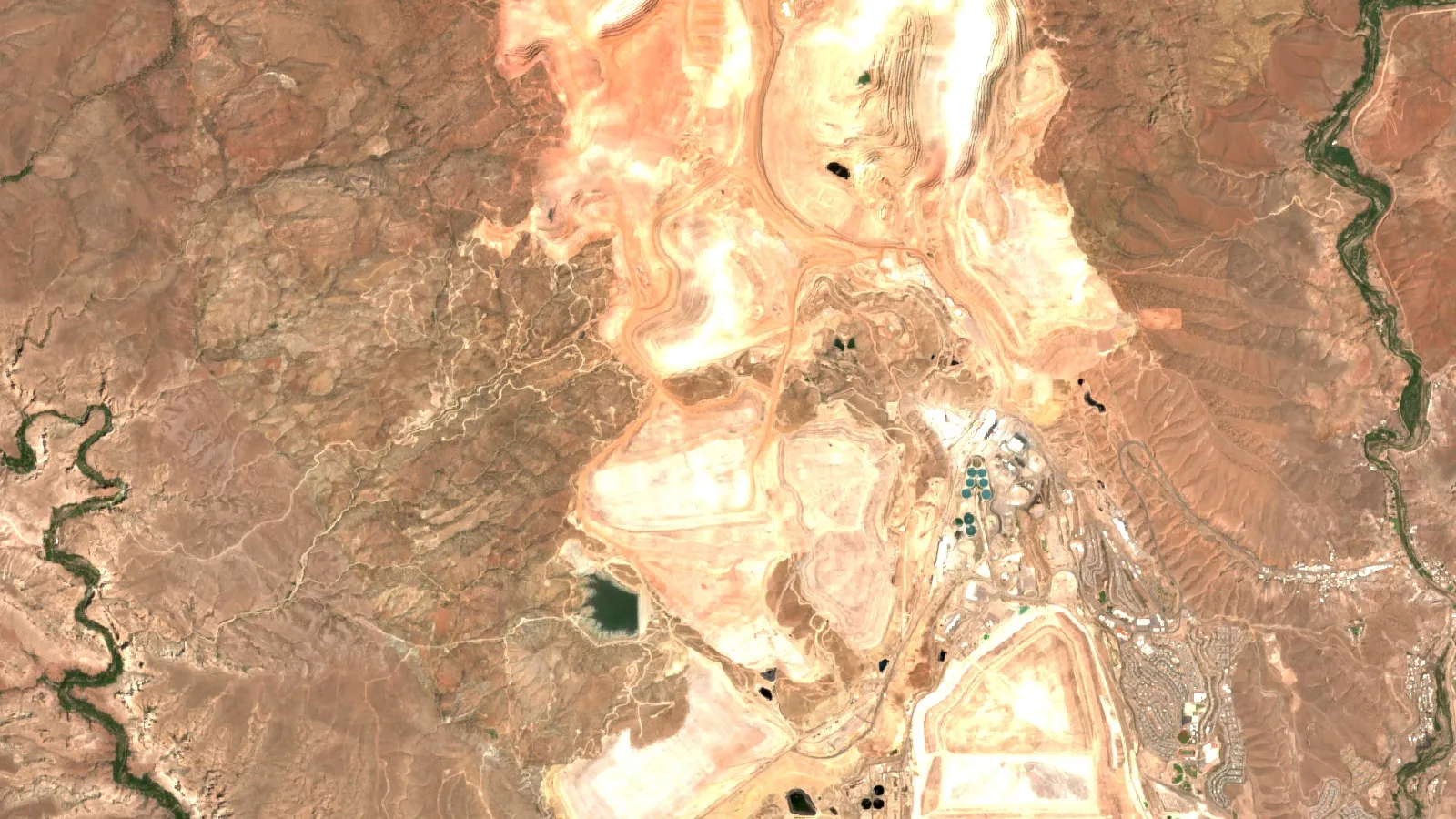

Sentinel-2 Satellite View Of Morenci Copper District, Greenlee County, Arizona
Sentinel-2 true-colour composite of Morenci copper district, Greenlee County, Arizona (33.07ยฐN, 109.37ยฐW). Contains modified Copernicus Sentinel data, 2022 to 2026, processed in Google Earth Engine.

Key takeaways

  • Warintza’s pre-feasibility study reports a post-tax NPV (8%) of US$4,617 million on US$3,729 million of initial capital at a US$4.50/lb copper price (Solaris, Nov 2025).
  • Copper World Phase I: NPV (8%) rises from US$463 million at US$3.25/lb to US$2,006 million at US$4.50/lb, a gain of about US$310 million per US$0.25 (Hudbay, 2023).
  • Tax matters: Warintza’s pre-tax NPV of US$7,492 million falls to US$4,617 million after tax, about 38% lower.
  • SEC rules set cost accuracy of about plus or minus 25% for a pre-feasibility study and 50% for an initial assessment (17 CFR 229.1302).
  • Freeport states a US$0.10/lb copper price change moves second-half 2026 operating cash flow by about US$150 million (July 2026).
In this article
  1. How a copper mine valuation works
  2. What stage of study is your copper project at
  3. Step 1: Set the project inputs
  4. Step 2: Pick a copper price and a revenue model
  5. Step 3: Estimate initial and sustaining capital
  6. Step 4: Break down operating cost per tonne and per pound
  7. Step 5: Add royalties, tax and the discount rate
  8. Step 6: Build the yearly cash flow
  9. Step 7: Test sensitivity to price, cost and capital
  10. Step 8: Check the model before you share it
  11. Copper supply and price context for the model
  12. What this means for investors reading a study
  13. Frequently asked questions

A copper mine is valued as the net present value (NPV) of its after-tax cash flows: the cash the mine is expected to earn each year, discounted back to today at a chosen rate. The Warintza pre-feasibility study in Ecuador shows the scale. It reports a post-tax NPV at an 8% discount rate of US$4,617 million on initial capital of US$3,729 million, using a long-term copper price of US$4.50 per pound (Solaris Resources, 6 November 2025). Change the price, the capital bill or the discount rate and that answer moves a lot. This guide shows how to build the model in eight steps, with real study numbers at each step and a calculator you can run on your own inputs.

It is written for investors, analysts and licence holders who read a technical study and want to check the number behind the headline. It is a method guide, not advice on any share or project. Terms are explained the first time they appear.

How a copper mine valuation works

Every copper mine valuation, from a first desk estimate to a bank model, follows the same chain. Ore is mined and processed. Copper is sold, usually as a concentrate (a powder of about 25-30% copper that smelters buy) or as cathode (refined 99.99% sheets from solvent extraction and electrowinning, called SX/EW). Revenue minus operating cost, tax and capital spending leaves net cash flow after capital. Net cash flow after capital in later years is worth less than cash today, so each year is divided by (1 + discount rate) raised to the year number. The sum is the NPV.

Infographic

Copper mine valuation in 5 moves

  1. 1InputsTonnes, grade, recovery and mine life from the study.
  2. 2PriceA long-term copper price plus low and spot cases.
  3. 3CostsCapital, operating cost, royalties and tax.
  4. 4Cash flowOne column per year, discounted at your rate.
  5. 5StressMove price, cost and capital to see the range.

The internal rate of return (IRR) is the discount rate at which the NPV is exactly zero. Payback is the number of years until cumulative cash flow turns positive. Hudbayโ€™s 2023 pre-feasibility study for Phase I of its Copper World project in Arizona reports all three at a copper price of US$3.75 per pound: an after-tax NPV at 8% of US$1,100 million, an IRR of 19.2% and a payback of 5.9 years (Hudbay Minerals, September 2023).

  1. Fix the project inputs: tonnes, grade, recovery, mine life.
  2. Choose a copper price and a sales model (concentrate or cathode).
  3. Estimate initial and sustaining capital.
  4. Estimate operating cost per tonne and per pound.
  5. Add royalties, tax and the discount rate.
  6. Run the cash flow and read NPV, IRR and payback.
  7. Stress the three biggest drivers: price, cost and capital.
  8. Check the study stage and the resource category behind the tonnes.

What stage of study is your copper project at

The same model means different things at different stages, because the cost accuracy changes. Two rule sets matter to most readers. In the United States, the SECโ€™s mining disclosure rule (17 CFR 229.1302) lets a company report mineral resources from an โ€œinitial assessmentโ€. A cash-flow analysis is optional at that stage, and if it is shown, costs must be accurate to about plus or minus 50% with contingency of no more than 25%. Mineral reserves must rest on a pre-feasibility or feasibility study, which must include a discounted cash flow analysis, cost estimates accurate to about plus or minus 25% and contingency of no more than 15% (17 CFR 229.1302, via Cornell Law School). The rule does not set a discount rate.

In Canada, the CIM Definition Standards say a pre-feasibility study is the minimum needed to convert mineral resources to mineral reserves, and that a feasibility study has a higher confidence level than a pre-feasibility study (CIM Definition Standards, 2014). Resources can be inferred, indicated or measured. Inferred resources have the lowest confidence, and the SEC rule bars them from the economic case in a pre-feasibility study.

Study stage What it can support Stated cost accuracy (SEC rule) Disclosure role
Initial assessment or preliminary economic assessment Mineral resources; cash flow optional About plus or minus 50%, contingency up to 25% Resource disclosure
Pre-feasibility study Mineral reserves; discounted cash flow required About plus or minus 25%, contingency up to 15% Reserve disclosure
Feasibility study Reserves and a financing decision; higher confidence than a pre-feasibility study About plus or minus 15%, contingency up to 10% Reserve disclosure and financing basis

Before you trust any NPV, note the stage, the date and the price deck. A 2023 study priced at US$3.75 per pound and a 2025 study priced at US$4.50 per pound are not comparable until you put them on the same price. Hudbayโ€™s MD&A dated 28 July 2026 says its new feasibility study is expected to show higher capital than the 2023 pre-feasibility study, because of cost inflation and mill expansion scope, so the 2023 capital figure should be read as old (Hudbay Minerals, MD&A to 30 June 2026).

Step 1: Set the project inputs

Start with the physical project. These inputs drive everything else, so write each one with its source.

  • Throughput: tonnes of ore processed per year.
  • Head grade: the average copper percentage in the ore fed to the plant. Copper equivalent (CuEq) grades add gold, silver and molybdenum credits and must be converted back to copper for revenue.
  • Recovery: the share of copper that ends up in the product. It often falls as the ore gets deeper or harder.
  • Strip ratio: tonnes of waste moved for each tonne of ore in an open pit.
  • Mine life: set by the reserve and the tailings storage design, not by hope.

Warintza gives a clean example of how inputs change over time. Average throughput is 60.2 million tonnes a year. The copper head grade is 0.44% in the first five years, 0.36% over the first 15 years and 0.31% over the life of mine, while recovery falls from 89% to 86% to 84%. Average annual copper output falls with it: 230,000 tonnes in the first five years, 183,000 over 15 years and 156,000 over the life (Solaris Resources, 2025). A model that holds grade flat will overstate late-life cash. For background on how these deposits form and why grades differ, see our guide to porphyry copper deposits, and for the structure of a resource model see mine modeling basics.

Open-pit mines carry waste; Warintzaโ€™s life-of-mine strip ratio is 0.53 tonnes of waste per tonne of ore, which Solaris describes as low. Underground mines usually have higher grades and higher unit costs. Put mining method and strip ratio in the model, because they set the cost per tonne in Step 4.

Step 2: Pick a copper price and a revenue model

Price is the largest single driver of value. The U.S. Geological Survey reports the London Metal Exchange (LME) grade A cash price averaged about 440 US cents a pound in 2025 (an estimate), up from 414.7 cents in 2024 (USGS, Mineral Commodity Summaries 2026). Producers report higher prices more recently: Freeport-McMoRanโ€™s average realized price was US$6.17 per pound in the second quarter of 2026, against US$4.54 a year earlier (Freeport-McMoRan, 23 July 2026).

Chart

Freeport copper price and unit cost, second quarter

US$ per pound of copper

Q2 2025Q2 202602468Average realized price4.56.2Unit net cash cost1.12.0Source: Freeport-McMoRan, second-quarter 2026 results, summary operating data (23 July 2026).
Q2 2025Q2 202602468Average realized price4.56.2Unit net cash cost1.12.0Source: Freeport-McMoRan, second-quarter 2026 results, summaryoperating data (23 July 2026).
The realized price rose by US$1.63 per pound while unit net cash cost rose by US$0.84, mainly on lower copper volumes at PT Freeport Indonesia (PTFI).

Study authors usually do not use the spot price. They set a long-term price, often below spot. Warintza uses US$4.50 per pound for copper and Copper Worldโ€™s 2023 study used US$3.75. The SEC rule requires the price to give a reasonable basis for judging economic extraction, with the reasons and the time frame disclosed. For your own model, run at least three cases: a low case, a base case and a spot case. Our note on copper price volatility covers why a single price is a weak basis.

Then convert metal to money. Revenue is not tonnes of copper times price. Smelters pay for only part of the copper in a concentrate, and they charge treatment and refining costs (TC/RC). Cochilco, the Chilean copper commission, adds a step it calls โ€œhomologation to cathodeโ€ in its cost definition, covering TC/RC and the change from contained to payable copper (Cochilco, Observatorio de Costos, May 2025). The concentrate grade you sell sets the freight and smelter terms; see typical copper concentrate grades.

By-products matter too. Warintza expects an average of 8,600 tonnes of molybdenum, 57,000 ounces of gold and 1.3 million ounces of silver a year over the first 15 years, and the study counts them as credits. If you take gold or molybdenum credits from a study, state their price assumptions beside the copper price.

Step 3: Estimate initial and sustaining capital

Capital has three parts: initial (pre-production) capital, sustaining capital that keeps the mine running, and closure cost. Warintzaโ€™s study has initial capital of US$3,729 million, which includes a 15.7% overall contingency, sustaining capital of US$1,713 million over the life and closure cost of US$200 million. Solaris also reports capital intensity of about US$15,440 per annual tonne of CuEq over the first 15 years. Capital intensity divides the initial capital by the average yearly output, which lets you compare projects of different size (Solaris Resources, 2025).

Copper World Phase I is a smaller project: US$1,323 million of initial growth capital, plus US$367 million in year four for a concentrate leach facility, which Hudbay deferred to cut the upfront bill (Hudbay Minerals, 2023). Deferral is a modelling choice with a cost: it lowers early spending, but it also moves some revenue later.

Check three things in any capital estimate. First, the contingency: a pre-feasibility study can carry up to 15% under the SEC rule, and the cost accuracy band is wider than most readers expect. Second, whether power, water, roads, a port and a tailings dam are inside the number. Third, the date: capital figures age quickly when steel, labour and equipment prices rise. If a project sits on federal land, add time for permits. Our guide to BLM mining claims explains how claims on U.S. federal land work.

Step 4: Break down operating cost per tonne and per pound

Operating cost is built bottom-up in dollars per tonne milled (mining, processing, general and administrative) and then converted to dollars per pound of payable copper. Warintzaโ€™s life-of-mine operating cost is US$8.75 per tonne milled, made up of mine operating cost of US$2.40, processing of US$5.58 and general and administrative cost of US$0.78 (Solaris Resources, 2025). Fleet size, haul distance and fuel use drive the mining line.

Chart

Reported unit costs for copper, US cents per pound

Definitions differ: AISC, sustaining cash cost, Cochilco C1 and Freeport net cash cost are not the same measure

0ยข50ยข100ยข150ยข200ยขWarintza AISC, years 1-585ยขWarintza AISC, life125ยขCopper World sust. cash181ยขChile C1, Cochilco 2024185ยขFreeport net cash, H1 2026194ยขSource: Solaris Resources (Nov 2025); Hudbay (2023); Cochilco, Observatorio de Costos (2024 data); Freeport-McMoRan Q2 2026release (six months, excluding idle facility costs).
0ยข50ยข100ยข150ยข200ยขWarintza AISC, years 1-585ยขWarintza AISC, life125ยขCopper World sust. cash181ยขChile C1, Cochilco 2024185ยขFreeport net cash, H1 2026194ยขSource: Solaris Resources (Nov 2025); Hudbay (2023); Cochilco,Observatorio de Costos (2024 data); Freeport-McMoRan Q2 2026release (six months, excluding idle facility costs).
Study costs for new projects sit near or below the cost reported by operating mines, but each bar uses its own definition.

Unit cost terms vary between companies, so know which one you are reading.

  • C1 cash cost: site operating costs plus transport, treatment and refining, minus by-product credits. It leaves out depreciation and corporate overhead. Cochilco states that its C1 measure is not a good guide to margins for this reason.
  • All-in sustaining cost (AISC): C1 plus sustaining capital and some overheads. Each company defines it a little differently.
  • Unit net cash cost: Freeport-McMoRanโ€™s version, net of by-product credits.

Net costs depend heavily on by-product prices. Freeport states that its unit net cash costs for the second half of 2026 change by about US$0.02 per pound of copper for each US$100 per ounce change in the gold price (Freeport-McMoRan, 2026). Costs also move for operating reasons. Freeportโ€™s unit net cash cost was US$1.97 per pound in the second quarter of 2026 against US$1.13 a year earlier, which the company attributes mainly to lower copper volumes at PTFI, its Indonesian operation.

Cochilcoโ€™s sample of 21 large Chilean copper operations, covering 94.3% of Chileโ€™s 2024 mine output, averaged a C1 cash cost of 184.9 US cents per pound in 2024, down from 192.1 cents in 2023. Cochilco notes that mines with lower output show higher cash costs. If your project is small, do not borrow a large mineโ€™s unit cost. Power and emissions-related costs also deserve a line in the model.

Step 5: Add royalties, tax and the discount rate

Royalties and taxes sit between operating cash flow and net cash flow after capital, and they differ by country, so use the local rule, not an average. The effect is large. Warintzaโ€™s pre-tax NPV at 8% is US$7,492 million and its post-tax NPV is US$4,617 million, a drop of about 38%. Its pre-tax IRR is 34% against 26% after tax, and its payback is 1.9 years before tax and 2.6 years after (Solaris Resources, 2025). Always compare NPVs on the same tax basis.

The discount rate reflects the time value of money and the risk of the project. Studies often show NPV at 8% and 10%, which makes the rate sensitivity visible: Copper Worldโ€™s 2023 study shows US$1,100 million at 8% and US$771 million at 10% at the same copper price. A riskier or earlier-stage project would normally be discounted at a higher rate. The SEC rule requires a discounted cash flow but does not name a rate, so the choice is yours and should be stated.

The calculator below is a flat-year simplification. It assumes a constant output and cost, capital spent at the start, straight-line depreciation for tax and no ramp-up. Real models handle each year separately. Use it to see how the main inputs combine, then replace it with a yearly sheet.

Calculator

What is a copper mine worth on your inputs?

Enter your own output, price, cost and capital to see a flat-year NPV.

kt/yr

US$/lb

US$/lb

US$M

US$M

years

%

%
1,961 US$Mafter-tax NPV
  • Annual margin before sustaining capital: 485 US$M
  • Annual after-tax cash flow: 353 US$M
  • Simple payback: 4.3 years

Example values only, not a forecast or any company’s figures. Prices are inputs: example, use today’s price. Simplified: constant output and cost, capital spent at the start, straight-line depreciation for tax, no ramp-up or working capital. Uses 2.20462 lb per kg; output in thousand tonnes is converted to million pounds.

Step 6: Build the yearly cash flow

A yearly model has one column per year, from the first construction year to the end of closure. For each year, calculate:

  1. Ore mined and processed, copper grade, recovery and payable copper.
  2. Revenue from copper and each by-product at the price deck.
  3. Operating cost, treatment and refining charges and royalties.
  4. Earnings before interest, tax, depreciation and amortisation (EBITDA).
  5. Depreciation, taxable income and income tax.
  6. Initial, sustaining and closure capital, and working capital.
  7. Net cash flow after capital, then the discount factor for that year and the discounted cash flow.

For scale, Warintzaโ€™s study reports average annual EBITDA of US$1,912 million in the first five years and US$1,156 million over the life of mine, with average post-tax net cash flow after capital of US$1,341 million and US$792 million over the same periods. Copper World Phase I reports average annual EBITDA of US$372 million and average sustaining capital of US$27.1 million a year. Both figures come from the company studies cited above and are on different price decks.

Keep the construction period in the model. Warintzaโ€™s initial capital is spent over a three-year construction period, so cash goes out well before revenue starts. A calculator that discounts all capital at year zero is kinder to the project than a real schedule. Model working capital as well, because the cash tied up in concentrate shipments and provisional pricing is real. Freeportโ€™s 10-K says it records copper sales at the then-current LME price and adjusts later, and that it had 152 million pounds of provisionally priced copper sales at 31 December 2025, recorded at an average of US$5.64 per pound (Freeport-McMoRan, Form 10-K for 2025).

Farmonaut Mining Pro course: costs, AISC, break-even price, NPV and payback in a mine plan.

โ–ถ Farmonaut Mining Pro course: costs, AISC, break-even price, NPV and payback in a mine plan. ยท 14:58

Step 7: Test sensitivity to price, cost and capital

A single NPV is a point on a curve. The useful output is how fast it moves. Hudbayโ€™s sensitivity table for Copper World Phase I shows the after-tax NPV at 8% rising from US$463 million at US$3.25 per pound to US$2,006 million at US$4.50 per pound. Each US$0.25 step adds roughly US$310 million. IRR climbs from 12.7% to 28.5% and payback falls from 7.9 to 4.4 years across the same range.

Chart

Copper World Phase I after-tax NPV by copper price

US$ million, 8% and 10% discount rates, Hudbay 2023 pre-feasibility case

$0M$625M$1,250M$1,875M$2,500M$3.25$3.50$3.75$4.00$4.25$4.50NPV at 8% $2,006MNPV at 10% $1,540MSource: Hudbay Minerals, Copper World Phase I pre-feasibility study, sensitivity table (September 2023).
$0M$625M$1,250M$1,875M$2,500M$3.25$3.75$4.50NPV at 8%NPV at 10%$2,006M$1,540MSource: Hudbay Minerals, Copper World Phase I pre-feasibilitystudy, sensitivity table (September 2023).
NPV at 8% rises more than fourfold between US$3.25 and US$4.50 per pound (US$463M to US$2,006M), and the 10% rate cuts value at every price.

Warintzaโ€™s study tested plus or minus 20% changes in prices, operating costs and initial capital. It found the NPV at 8% is most sensitive to the copper price, with operating costs second and initial capital third, followed by the molybdenum price. A different project may rank these differently, so run your own test: move one input at a time by 10% and 20% and record the NPV.

Price sensitivity is also visible at producers. Freeport states that a US$0.10 per pound change in the average copper price in the second half of 2026 would change operating cash flows by about US$150 million. Freeport expects sales of about 3.1 billion pounds of copper in 2026, so small price moves carry large dollar effects.

Add a downside case that combines a lower price, a 15-20% capital overrun and a one-year delay. Then add a break-even view: the copper price at which NPV is zero, the cost at which it is zero, and the capital at which it is zero.

Step 8: Check the model before you share it

  • Source every input. A reader should see where each price, grade and cost came from, with its date.
  • Check the resource category. Do not let inferred resources into the economic case; the SEC rule bars this for a pre-feasibility study.
  • Check units. Pounds against tonnes (1 tonne is 2,204.62 pounds), short tons against metric tonnes, and US$ against C$ or A$.
  • Check circularity. Taxes, interest and working capital can create loops that break a spreadsheet.
  • Reconcile. Production, revenue and cost per pound should reproduce the study table you started from, to within rounding.
  • Separate fact from view. Label which numbers are study results and which are your own assumptions.

Satellite data can help before the model exists, by screening a licence area for alteration and structure that guide where to drill. It does not produce a reserve or a cash flow, and any result is an exploration target until drilling and a qualified person confirm it. To see how screening fits with ground work, read about remote sensing in copper prospecting and where copper is found in the United States.

What Monte Carlo P10/P50/P90 means for price, grade and cost uncertainty in mine economics.

โ–ถ What Monte Carlo P10/P50/P90 means for price, grade and cost uncertainty in mine economics. ยท 14:59

Copper supply and price context for the model

World mine production of copper was an estimated 23 million tonnes in 2025, the same as 2024, and world reserves are 980 million tonnes (USGS, 2026). Chile leads production at 5.3 million tonnes (2025 estimate), followed by the Democratic Republic of the Congo at 3.2 million tonnes and Peru at 2.7 million tonnes (USGS, Mineral Commodity Summaries 2026). The United States produced about 1.0 million tonnes in 2025, valued at an estimated US$11 billion, and USGS gives a net import reliance of 57% of apparent consumption.

Chart

LME grade A copper price, annual average

US cents per pound; 2025 is a USGS estimate

0ยข120ยข240ยข360ยข480ยข422ยข2021400ยข2022385ยข2023415ยข2024440ยข2025eSource: USGS, Mineral Commodity Summaries 2026, Copper, salient statistics (February 2026).
0ยข120ยข240ยข360ยข480ยข422ยข2021400ยข2022385ยข2023415ยข2024440ยข2025eSource: USGS, Mineral Commodity Summaries 2026, Copper,salient statistics (February 2026).
Annual averages stayed between about 385 and 440 cents a pound across 2021-2025.

These figures matter for a valuation because they show which price level the industry has been selling at and how fast supply is moving. The annual LME average price in USGS data was 422.5 cents per pound in 2021, 399.8 in 2022, 384.8 in 2023, 414.7 in 2024 and an estimated 440 in 2025. A valuation that assumes a long-term price well above that range needs a reason.

Where the copper in an electric vehicle comes from, and why it matters for supply.

โ–ถ Where the copper in an electric vehicle comes from, and why it matters for supply. ยท 6:03

What this means for investors reading a study

If you hold or follow a copper developer, you can test a press release in ten minutes. Find the price deck, the discount rate and the stage of study. Look up initial capital and divide by annual copper output to get capital intensity. Compare the AISC with a peer on the same definition. Then move the copper price down by US$0.50 per pound and see how much NPV remains. If the project only works at the top of the price range, that is the main risk to weigh.

Note also that some studies are old. Copper Worldโ€™s published economics are from 2023, and the company has said the next study will show higher capital. A recent price rise does not fix an old cost base. Taseko, which reported first copper cathode at its Florence Copper in-situ recovery project in Arizona in February 2026, is a different project type: it recovers copper in place from wells and needs no conventional open pit (Taseko Mines, 18 February 2026). Different project types need different cost models.

For a closer look at a related question, see our guide: Mineral Titles Online: How BC Claims Work, Step by Step.

If this topic matters to you, read Copper Smelting Process Control: Targets by Step next.

Frequently asked questions

How do you value a copper mine?

Build a yearly cash flow from production, price, operating cost, tax and capital, discount it at a chosen rate, and sum it to get the net present value. Then test price, cost and capital changes. Warintza and Copper World are two public examples with full tables.

What discount rate should I use for a copper mine?

There is no single rate. Public studies often show 8% and 10%. Copper Worldโ€™s 2023 study shows US$1,100 million at 8% and US$771 million at 10%. Use a higher rate for earlier-stage or higher-risk projects and state your choice.

What copper price should a valuation use?

Use a long-term price you can defend, plus a low case and a spot case. Warintza used US$4.50 per pound and Copper World used US$3.75 per pound in their studies. Spot prices are higher at times, as Freeportโ€™s realized price of US$6.17 per pound in the second quarter of 2026 shows.

What is the difference between NPV and IRR?

NPV is the value in dollars today after discounting. IRR is the discount rate at which NPV is zero. NPV tells you how much value; IRR tells you how well the capital is used. Use both with the payback period.

What is C1 cash cost and how is it different from AISC?

C1 covers site operating cost plus transport, treatment and refining, less by-product credits. AISC adds sustaining capital and some overheads. Neither includes the full initial capital, so neither tells you if the project makes a profit.

How much does a copper mine cost to build?

It depends on size, grade, location and process route. Warintzaโ€™s pre-feasibility study shows initial capital of US$3,729 million for about 60 million tonnes of ore a year. Copper World Phase I shows US$1,323 million plus US$367 million later. Compare projects using capital intensity, not total cost.

Can I use inferred resources in a valuation?

Not in the economic case for a pre-feasibility study under the SEC rule. An initial assessment may use them only if it is labelled preliminary, the share of inferred resources is disclosed and results without them are shown with equal prominence.

What is the typical accuracy of a copper mine study?

The SEC rule states about plus or minus 50% for an initial assessment cash flow and about plus or minus 25% for a pre-feasibility study. A feasibility study must reach about plus or minus 15%. Treat any NPV as a range rather than a point.

What affects a copper mine valuation most?

For Warintza, the study ranks the copper price first, operating costs second and initial capital third. Grade changes have almost the same effect as price changes. Check this ranking on any project you are looking at.

Does a mine plan need by-product credits?

Many porphyry copper mines earn gold, silver or molybdenum. Warintza counts them, and Freeportโ€™s net cash cost responds to gold and molybdenum prices. State their price assumptions or show a copper-only case.

Can I build a copper mine model in a spreadsheet?

Yes. A yearly spreadsheet with an inputs sheet, a production sheet, a cost sheet and a cash flow sheet is standard. Avoid hard-coded numbers inside formulas and keep a log of sources.

Is a copper mine valuation the same as a share price valuation?

No. A mine NPV values the asset. A share price also reflects debt, other assets, partners, dilution and market views. This page is about the asset model only and is not investment advice.

This page is for information only. It is not investment advice. Study figures are the companies’ own results at the dates and prices shown.

Authored by: Farmonaut Research & Content Team

Reviewed and verified by: Farmonaut Mining & Mineral Exploration Team

Reviewed October 2026 against the Warintza and Copper World study releases, Freeport-McMoRan’s 2025 Form 10-K and Q2 2026 release, USGS Mineral Commodity Summaries 2026, Cochilco’s cost report and 17 CFR 229.1302.

Farmonaut mining

Screen your own licence area from space

Farmonaut's satellite exploration reports show alteration and structure targets on a licence before you plan drilling; results are exploration targets, not resources.

Farmonaut Mining Pro 3D Target View (Sample, Synthetic Data)

Mining Pro sample view, synthetic data

Sources

  1. USGS, Mineral Commodity Summaries 2026: Copper (Feb 2026): pubs.usgs.gov
  2. 17 CFR 229.1302, Individual property disclosure (Cornell Law School): law.cornell.edu
  3. CIM Definition Standards for Mineral Resources and Mineral Reserves (2014): mrmr.cim.org
  4. Solaris Resources, Warintza pre-feasibility study results (6 Nov 2025): solarisresources.com
  5. Hudbay Minerals, Copper World Phase I pre-feasibility study news release (Sept 2023): s23.q4cdn.com
  6. Hudbay Minerals, MD&A for the period to 30 June 2026 (SEC filing, 28 Jul 2026): sec.gov
  7. Freeport-McMoRan, second-quarter 2026 results (23 Jul 2026): s22.q4cdn.com
  8. Freeport-McMoRan, Form 10-K for 2025: s22.q4cdn.com
  9. Cochilco, Observatorio de Costos 2024 vs 2023 (May 2025): cochilco.cl
  10. Taseko Mines, fourth-quarter results and Florence Copper production (18 Feb 2026): investegate.co.uk



Discussion

Questions, corrections or field experience? Share them below. First-time comments are reviewed before they appear, and your email is never published.

No comments yet. Be the first to add a question or your experience.

Leave a comment

Farmonaut Farmonaut Trusted by 200,000+ users and 100+ businesses 200,000+ users trust us Get started
